A compact substation is a decision made at the start of a project, not a substitution for a switchroom at the end of it. Buying a prefabricated substation means buying the enclosure, the medium-voltage switchgear, the transformer and the low-voltage distribution as one factory-assembled and factory-tested package, delivered to a foundation and energised in a fraction of the time a conventional brick-and-concrete substation requires.

This guide explains what the package contains, the main construction types and where each fits, the specification points that decide whether the unit works for twenty-five years, and the documentation and procurement questions worth settling before you place the order. The wider power distribution solutions that prefabricated units replace are worth understanding first, because they define the interfaces.

What a Prefabricated Substation Contains

Designs vary, but a complete unit normally includes:

  • Medium-voltage switchgear: a ring main unit, load break switch or circuit breaker assembly with protection and, where required, metering. A compact ring main unit with load break switches is the usual building block for small and medium-sized units.
  • A transformer: oil-immersed or dry-type, selected for the installation environment, fire strategy and loss performance.
  • Low-voltage switchgear: incoming breaker, outgoing feeder protection, power factor correction, surge protection and metering, supplied either as a panel inside the enclosure or as an outdoor low voltage distribution cabinet alongside it.
  • The enclosure: a weatherproof, insulated housing with doors, ventilation, lighting, access for cable entry and, where needed, a walk-in compartment.
  • Auxiliary systems: anti-condensation heating, ventilation or cooling, internal wiring, earthing provisions, and often remote monitoring and communications.
  • Documentation: drawings, test certificates, protection settings and an operations and maintenance manual.

The value of the package is integration. Cable termination, interlocking, protection testing and routine tests are completed and repeated in the factory under controlled conditions instead of being assembled and verified on a site with a limited weather window.

Construction Types and Where Each Fits

TypeArrangementTypical application
European-style box substationCompartmented enclosure with separated MV, transformer and LV rooms, often walk-inUtility and industrial distribution where inspection access is needed
American-style or pad-mountedCompact tamper-resistant enclosure at ground level, fed by underground cableResidential and commercial developments with buried distribution
Skid-mounted packageComplete assembly mounted on a common steel base for simple handlingRapid deployment where transport and installation time matters
Container or E-houseFull switchroom built inside a standard container structureLarge lineups, remote sites and projects needing an expandable building
Compact single-unitIntegrated MV, transformer and LV in one small enclosureSmall loads, including charging stations and renewable generation blocks

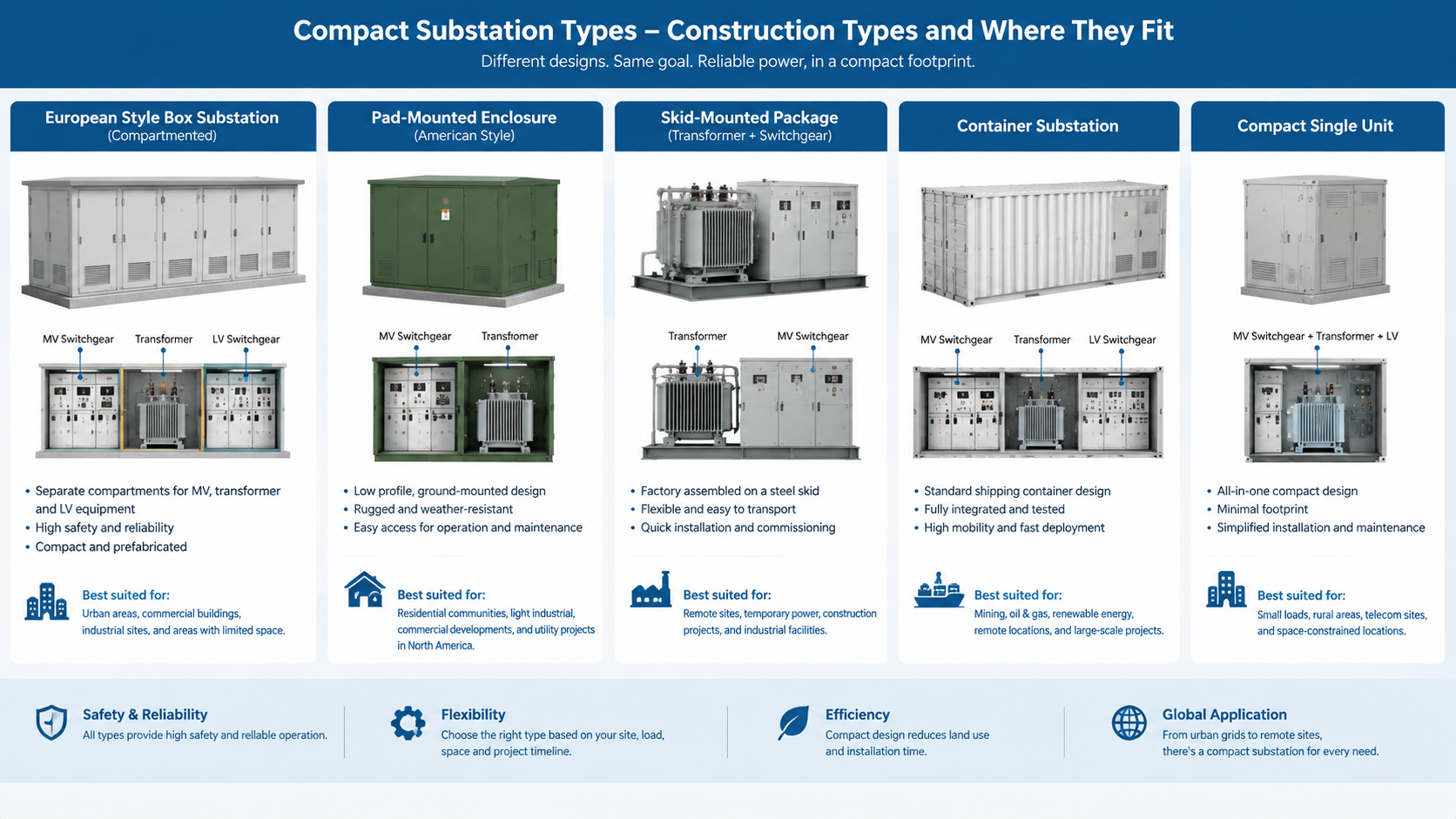

Comparison of compact substation types showing a European style compartmented box substation, a pad-mounted enclosure and a container substation with medium voltage switchgear and transformer

Insulation technology is a separate decision from the enclosure type. Sealed gas-free designs are increasingly specified where the unit sits in a public or environmentally sensitive location, and the trade-offs are set out in our comparison of AIS and GIS switchgear.

When a Compact Substation Beats a Conventional Switchroom

  • Space is constrained: the footprint is a fraction of an equivalent switchroom and needs no separate building.
  • The programme is tight: civil works collapse to a foundation and cable trenches, and the electrical assembly arrives complete.
  • The site is remote: fewer trades on site, less weather exposure and fewer return visits.
  • The installation may be relocated: a package can be dismantled and moved where a building cannot.
  • Load growth is phased: units can be added alongside existing ones as demand increases.
  • Site conditions are hostile: the enclosure controls the environment the equipment sees, which extends life in dusty, humid or coastal locations.

The trade-offs are equally real. Service access is tighter than in a dedicated building, transformer ratings are limited by what fits, and expansion beyond a certain capacity usually means adding a second unit rather than extending the first.

Specification Checklist

Most problems with prefabricated substations trace back to a specification that described the electrical ratings but not the environment or the interfaces. Work through all of these:

  1. System voltage and insulation level: rated voltage, withstand levels and the earthing arrangement expected by the network operator.
  2. Current ratings and fault level: continuous current for the final load, and short-circuit withstand matching the prospective fault current at the point of connection.
  3. Transformer: rating, type, vector group, impedance, taps, loss performance and, where harmonic loads are present, a suitable harmonic rating. Note that transformers are typically sourced as a paired item rather than by the switchgear manufacturer, so the interface between them must be defined explicitly.
  4. Protection: relay functions required, settings philosophy, trip circuits and interlocks, and whether remote indication is needed. Where a transformer feeder is protected by fuses rather than a relay, the fuse characteristic drives the coordination — see the guide to HRC fuse construction and types.
  5. Metering: revenue or operational metering, submetering, and the communications protocol expected by the owner’s monitoring system.
  6. Enclosure: ingress protection rating, material and coating for corrosion, insulation and cladding, door arrangement, locking and tamper resistance.
  7. Thermal management: ventilation or cooling sized for the actual losses at the local ambient, plus anti-condensation measures.
  8. Cable entry: top or bottom entry, number and size of entries, and the clearances the installer will need.
  9. Foundation and earthing: base dimensions, weight, earthing terminals and the earth electrode arrangement.
  10. Environment: ambient temperature range, altitude, humidity, seismic requirement, and wind or snow loading where relevant.

Sizing and Layout Considerations

Sizing starts with the load and the fault level, but layout follows from access and cable routing. Allow enough working space in front of the switchgear for racking a breaker out and for safe operation in arc-rated clothing, and confirm that the doors open without obstructing an access route. Check the transformer’s ventilation requirement against the position of the enclosure, and verify that the heat it rejects does not simply recirculate into the MV compartment. Where the enclosure is installed against a wall or in a recess, confirm that the specified IP rating is still achieved with the intended airflow, and design drainage so that standing water cannot reach the cable entry.

Transport deserves early attention too. Units are heavy, and access to the foundation may be limited by gate widths, overhead lines or ground bearing capacity. Planning the lift is cheaper than discovering the problem on delivery day.

Standards, Tests and Documentation

A prefabricated substation should be supplied against the relevant standards for both the assembly and its internal components, with type and routine test evidence. What to ask for:

  • Type tests for the switchgear and for the assembly, including internal arc testing where personnel access is possible.
  • Routine tests for every delivered unit, with certificates traceable to the serial number.
  • Factory acceptance testing with the buyer present or represented, covering protection operation, interlocking and functional checks.
  • Drawings and settings: general arrangement, schematic diagrams, protection settings and the coordination study behind them.
  • Operations and maintenance documentation: including spare parts lists and recommended inspection intervals.

For anything beyond a small unit, insist that the enclosure environment is specified rather than assumed. A unit whose thermal design was never checked against the local summer ambient and the transformer losses will derate in service, and the derating will not be recoverable.

Closing the Gap Between Order and Energisation

The delivery itself is short compared with the preparation. Before the unit arrives, the foundation should be cured and level, the earth electrode installed and tested, the cable routes prepared, and the protection settings agreed with the network operator. Gas or oil handling requirements, if any, should be planned, and the commissioning plan should set out who tests the transformer, who verifies the protection, and who confirms the interfaces between the switchgear and the transformer. Handled this way, a prefabricated substation can be energised within days of delivery instead of weeks.

Conclusion

A prefabricated or compact substation is bought as a system, not as a shelter with equipment inside it. Decide the construction type from the site and the load, specify the enclosure environment as carefully as the electrical ratings, settle the transformer interface explicitly, and require the type, routine and factory acceptance evidence that lenders and network operators will ask for. Get those right and the package delivers what it promises: a faster programme, a smaller footprint and a controlled environment for the equipment inside.

Send us the load schedule, fault level, site conditions and the space available, and we will advise on the compact substation configuration, and how it compares with a conventional switchroom using our medium and high voltage switchgear and low voltage switchgear ranges.

FAQ

What is a prefabricated substation?

It is a factory-assembled substation package containing the medium-voltage switchgear, transformer and low-voltage distribution inside a weatherproof enclosure. It is built and tested in the factory, delivered to a prepared foundation and connected on site, replacing a conventional substation building.

What is the difference between a compact substation and a prefabricated substation?

The terms overlap. Compact usually describes the physical size of a small unit with integrated switchgear and transformer, while prefabricated emphasises factory assembly and testing. A compact substation is almost always a prefabricated one.

What is a skid-mounted substation?

A complete substation assembly mounted on a common steel base so it can be lifted and positioned as a single unit, used where handling simplicity and fast deployment matter more than minimum footprint.

Do compact substations include the transformer?

Usually yes, as a paired item selected for the installation. Because transformer and switchgear are often supplied by different manufacturers, the interface between them — primary connections, protection, earthing and thermal coordination — should be defined explicitly in the specification.

What documentation should be supplied with a prefabricated substation?

Type test certificates for the switchgear and the assembly, routine test certificates for the delivered unit, factory acceptance test records, general arrangement and schematic drawings, protection settings with the coordination study, and operations and maintenance documentation including spare parts.
